StereoCloud3D
← All stories

A tunnel,
unrolled flat

A road underpass about 53 metres long, inside a larger survey. A tunnel is not outlined by hand: the program recognises it by looking upward from the floor, measures it section by section, and produces the drawings a tunnel inspection needs, including the lining unrolled into a single image.

Step 1

Two clicks along the road

The axis of the underpass is traced with two points, one at each end: 52.9 metres. That is all the operator draws. Everything that follows is measured from the cloud.

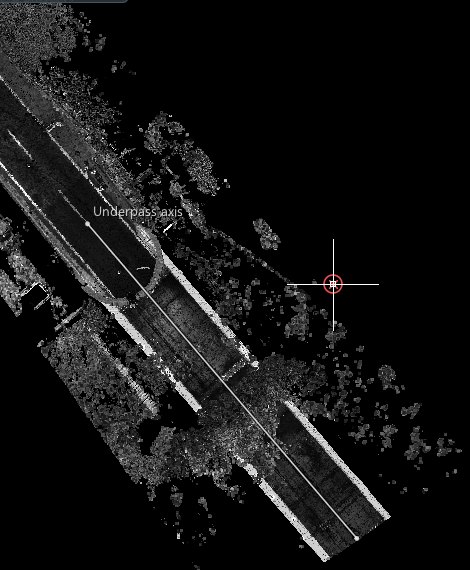

The underpass axis traced on the cloud of the road

In the user guide: Tunnel and underpass →

Step 2

Found and measured, every 25 cm

From the axis the program finds the alignment and cuts 212 sections over 52.8 metres. The surface is resolved on 88.3% of the lining, with a median radius of 3.95 m. Alignment and sections are drawn on the cloud, and with one click they go into the CAD drawing.

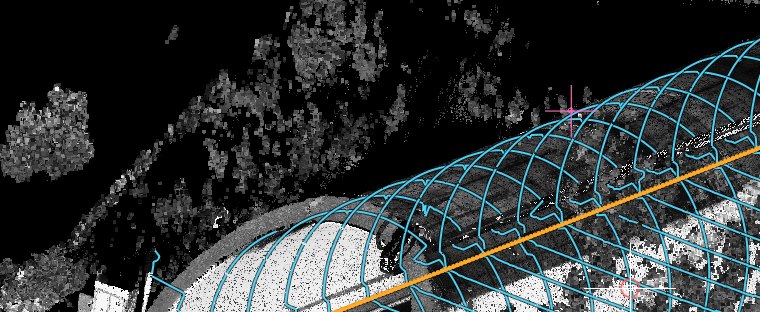

Sections measured along the tunnel, drawn over the cloud
Step 3

The lining, unrolled

The whole vault is unrolled into one flat image, half a degree per pixel: walls and crown side by side, with the road down the middle. Joints, stains and fittings can be read along the whole length at once.

The tunnel lining unrolled into a flat image
Step 4

Every section, as a drawing

Each cross section becomes a clean outline every 2.5 metres, ready to be measured or compared with the design profile. A slider moves from one to the next.

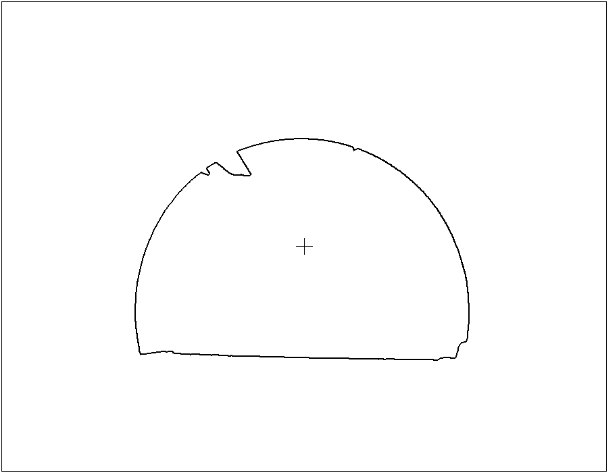

One cross section of the tunnel as a clean outline
Step 5

The road, and the crown above it

The pavement plan at 2 cm per pixel, with the markings and the drains; the crown seen from below, the view an inspector would have looking up. Walls, longitudinal profile, portals and the plan from above complete the ten deliverables, generated together.

Pavement plan of the underpass with markings and drains
The crown of the tunnel seen from below
